A38 Junction

Work on the A38 junction is underway. This page will be home to updates from Crest and their contractors O'Brien as the works continue. Updates will also be shared via Facebook and the Parish Council mailing list (sign-up at the bottom of the page). We have a separate page showing the plans for the junction and describing how it will work.

NB: Whilst the Parish Council has no control over works conducted by Crest and its contractors, we want to ensure residents get the right information. We have therefore agreed with Crest that we will share information provided by them, and will do so in a way that clearly shows it comes from Crest.

25 June - Responses to issues raised at event and updated TMP

Crest have provided:

  • An updated Traffic Management Plan (TMP) containing extra detail from Gloucestershire County Council and Stagecoach.
  • A report outlined some of the actions taken upon resident request raised at the 10 June information event and explaining why others can’t be taken.

We're advised that the best way to raise issues with the junction works is via GCC's FixMyStreet. Traffic officers have responded to issues raised in that way and are the people able to take action, rather than Crest Customer Services.

10 June 2025 - Material from information evening

At the residents' information event, Crest and O'Brien showed how the works are broken into four phases, for which they have approximate dates (subject to change). You can see the material here and we've summarised it in the following table.

  Approximate dates Basic details
Phase 1

9 June to 1 August

(8 weeks)

  • A38 is one lane only each direction (left hand lane closed)
  • Slip from A38 to Hardwicke/Quedgeley closed
  • Flyover closed
  • Exit from Davy Way closed
Phase 2

4 August to 19 September

(7 weeks)

  • A38 is one lane only each direction (right hand lanes closed)
  • Slip from A38 to Hardwicke/Quedgeley open
  • Flyover closed
  • Exit from Davy Way closed
Phase 3

22 September to 31 October

(6 weeks)

  • All lanes open on A38
  • Slip from A38 to Hardwicke/Quedgeley open
  • Flyover closed
  • Exit from Davy Way closed
Phase 4

3 to 28 November

(4 weeks)

  • Junction now open except connection from Hunts Grove to Cross Keys.
  • All lanes open on A38
  • Flyover open
  • Exit from Davy Way open



4 June 2025 - Progress update and information event (from Crest Nicholson)

Dear residents,

We are pleased to confirm that work on the primary Hunts Grove access (A38 junction) is running to schedule.

The initial phase within Hunts Grove - along the extension road onto Haresfield Lane and on the drainage pond - is progressing inline with the current site programme,

The team also now has Gloucestershire County Council approval of the Traffic Management Plan [see below] for works beyond the community's boundary. This will commence on Monday, 9 June, with a target finish date of Sunday, 30 November 2025.

We recognise that this announcement will inevitably cause some inconvenience and would like to thank you for your ongoing patience. Our contractor, O'Brien, has an extremely experienced team who are mindful of the need to minimise disruption to residents. Together, we will issue information about diversions and speed restrictions via the Parish Council, with ongoing updates as the project progresses.

Information Event: A38 roadworks

In addition we are holding a Residents' Information Evening about the works, with associated plans. Members of Crest's and O'Brien's teams will be in attendance and happy to answer your questions:

  • Tuesday, 10 June 2025
  • 4-7pm
  • Holiday Inn Express, Waterwells Business Park, Gloucester, GL2 2AB - Malvern Room

Please do come along and find out more. We look forward to seeing you there!

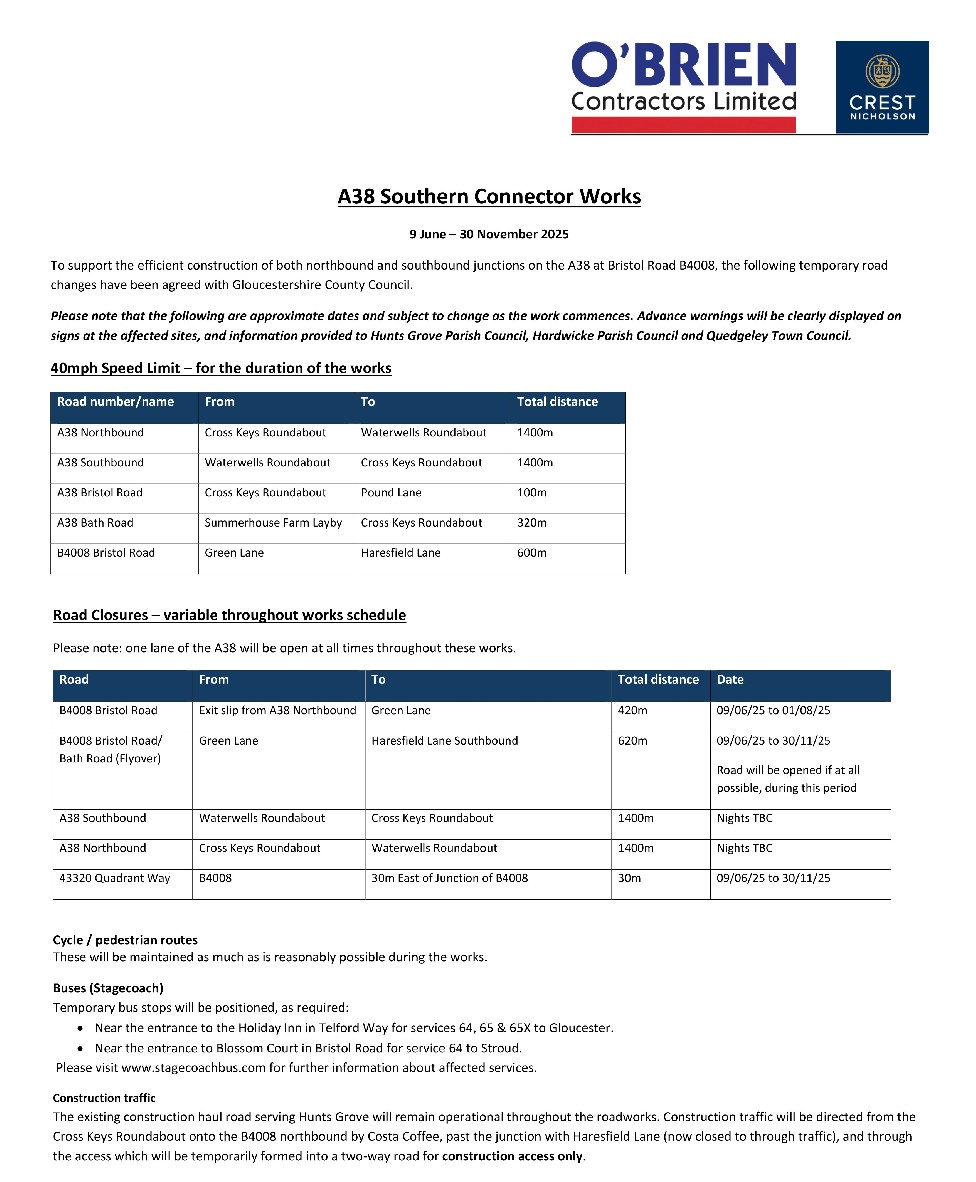

4 June 2025 - Traffic Management Plan (from O'Brien)

Click for PDF copy
